Most organisations want two things at once: the pace and adaptability of agile and the confidence that comes from clear governance. PRINCE2 supplies that confidence. Agile supplies the pace. They can live together, not as uneasy neighbours, but as a workable system you can run week after week. It takes some careful choices, nothing exotic.
PRINCE2 is a structured method for directing and controlling projects. It rests on seven principles:
- continued business justification,
- defined roles and responsibilities,
- management by stages,
- management by exception,
- a focus on products,
- learning from experience,
- and tailoring to suit the project environment.
In practice, PRINCE2 offers a compact set of processes and management products that make accountability visible and important decisions repeatable. The method does not prescribe how teams build software or services; it is neutral on delivery technique, which is exactly why it pairs well with iterative work.
Agile is a family of approaches that deliver value in small batches with frequent feedback. Teams manage a rolling backlog, collaborate closely with customers, and inspect and adapt in short cycles. Scrum (management framework) timeboxes work into sprints with clearly defined roles. Kanban systems limit work in progress and optimise flow. Agile shines when requirements move, when uncertainty is real, and when early learning is more valuable than late precision.
It can be helpful to see the blend in a simpler format to understand the relationship. PRINCE2 answers who decides, what controls apply, and why the investment still makes sense. Agile answers how the work is discovered, built, and validated quickly. With that foundation, the rest of this article shows how to connect the two so governance stays light and delivery stays quick.
Start with the mindset
PRINCE2 is principle-based and intentionally tailored. Agile welcomes change and expects discovery. When they meet, you do not bolt one on top of the other. You hold on to the PRINCE2 principles and adjust the mechanics so teams move fast without losing control. Even though the overall expression changes once both are integrated, the principles remain intact.
The rate of progress verification is the first shift. Replace large, infrequent checkpoints with smaller, more regular conversations. Plans become layered and rolling. At the project level you keep a product-based plan and a stage plan. At the team level you run sprint or flow plans that evolve week by week. Meanwhile, quality stays central through acceptance criteria, with a clear definition of completion, automated tests, and frequent reviews. The intent of PRINCE2 and Agile together is quite straightforward: keep purpose sharp, avoid paperwork that slows people down.

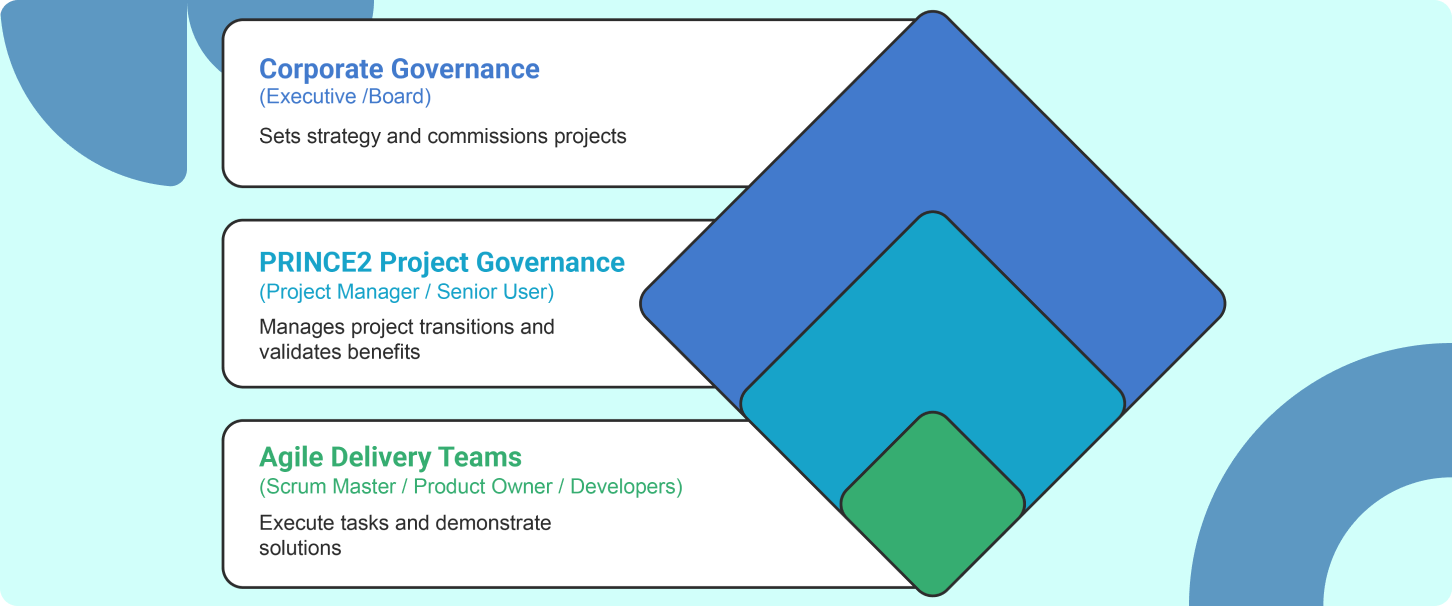

Governance and roles that actually fit
At the top, corporate or program governance sets strategy, investment themes, and expected benefits, commissioning PRINCE2 projects when a discrete investment with a clear start and end is appropriate. In the middle, PRINCE2 project governance provides the business case, approves stage transitions, delegates authority through tolerances, and validates benefits. On the ground, agile delivery teams use Scrum, Kanban, or a hybrid to manage a backlog, work in short timeboxes, and demonstrate working solutions regularly. The interface between layers is quite the fundamental weak point, so keep handoffs explicit and tight.
Another key element in PRINCE2 and Agile integration is to avoid duplicate roles. Merge responsibilities where it makes sense and be clear about decision rights. The Executive owns the business case and overall value. The Senior User represents customers and end users and partners with the Product Owner to prioritise outcomes and accept increments, acting as an escalation path across teams. The Senior Supplier owns solution viability and supplier commitments and works with delivery leadership to remove impediments that sit beyond a single team. The Project Manager coordinates planning at the project layer, manages risks and dependencies, and prepares information for the board while leaving day-to-day task management to agile team leads. The Product Owner orders the backlog and accepts increments as the single voice of priority. The Scrum Master or Delivery Manager coaches the team in flow and agile practices and escalates system-level impediments. Keep a short RACI for a handful of key decisions so accountability is visible, not implied.
Planning with stages and timeboxes
PRINCE2 manages by stages while agile delivers in short cycles, so nest one inside the other. Choose a stage length that ties to meaningful governance decisions, often six to twelve weeks, and aim for a coherent outcome such as a releasable slice or a validated capability. Inside the stage, teams run two-week sprints for Scrum or continuous flow for Kanban. Treat each stage boundary like a release review and a go or no go checkpoint in one session. Confirm continued business justification, review benefits evidence, update risks, and agree the next stage plan. Keep the ceremony short and evidence-based. Leaders get a clear investment rhythm; teams keep their delivery heartbeat.
Curating documentation that leaders will benefit from
You do not need more documents, you need the right information at the right time. By using Agile-infused PRINCE2, keep the Business Case short and alive by summarising drivers, options, expected benefits, costs, and risks, then link benefits to measurable outcomes you will check at stage boundaries. Use a concise Project Brief and a focused Project Initiation Documentation to describe product vision, high level scope by outcomes, major risks and constraints, the delivery approach, and the governance model. Replace long schedules with a simple product roadmap and an initial stage plan. Maintain a lightweight Product Breakdown Structure and Product Descriptions that translate cleanly into backlog items with clear acceptance criteria.
The Stage Plan should state objectives, controls, tolerances, and dependencies for the period and reference the backlog and team cadence rather than duplicating task-level plans. Swap bulky reports for one-page views that show value delivered this stage, forecast against tolerances, major risks, and the decisions the board needs to make. If a visual tells the story, prefer it to prose. The goal is not to create complicated documentation, but to be consistent in the process of it.

Controls, reporting, and tolerances in practice
Manage by exception through tolerances that fit the AGILE workflow. Fix time and cost tightly at the stage level by keeping a stable sprint cadence and team size, and raise an exception to the board if either is forecast to be exceeded. Flex scope and quality intelligently by combining prioritisation techniques such as MoSCoW with a clear Definition of Done, protecting compliance and critical quality while allowing lower value scope to move. Monitor risk and benefits as first-class targets, using early increments to retire high risks and gather real benefits data. If the benefits no longer justify the investment, stop any further involvement.
Make the controls feel natural by wiring team tools straight into governance. The product backlog maps to the product-based plan and Product Descriptions and remains the single source of truth for what might be delivered. Sprint backlogs and Kanban boards mirror the stage plan and show progress and forecast within the stage. Sprint reviews and demos feed the project manager’s highlight report and give the board direct evidence of value delivered. The Definition of Done and acceptance criteria anchor the Quality Management Approach and the Quality Register, with evidence captured through automated tests, checklists, and sign-offs in tools.
Leaders need insight, not noise. Issue a one-page highlight report at a stable cadence that matches the sprint length and shows stage objectives, value delivered, forecast against tolerances, the top risks and impediments, and the decisions required. When tolerances are breached, send an exception report that sets out the impact, options, and a recommended decision so the board can respond quickly. Replace formal checkpoint reports with lightweight updates drawn from sprint reviews and burn charts, curated by the project manager. Automate as much as possible by pulling facts from delivery tools in implementing Agile-infused PRINCE2.
Risk, quality, and change without the friction
The PRINCE2 practices do not disappear in agile, they are expressed through everyday routines. Keep a visible risk register and use hypothesis-driven development to reduce the unknowns early, then bake risk-based tests into the Definition of Done. Define quality criteria up front and connect them to automated checks, peer reviews, and acceptance steps, and hold a quality control bar that is not traded away without an explicit exception. Most change is handled through backlog ordering, but create a small change authority for compliance or architectural decisions that cannot be traded within normal prioritisation.
A practical rollout plan
If you are introducing PRINCE2 into an agile environment or the other way round, use a phased approach.
- Assess the current state. Capture how decisions are made today, where projects fail, and who owns value. Identify friction points such as slow approvals or unclear priorities.
- Define the governance model. Draft the project board composition, decision rights, and tolerances. Write a one-page governance charter and review it with senior stakeholders.
- Create tailored templates. Produce short, focused templates for the Business Case, PID, Stage Plan, Highlight Report, and Exception Report. Aim for clarity over completeness.
- Pilot on one project. Choose a project with a committed sponsor and a motivated team. Limit the pilot to two or three stages so you can learn quickly.
- Instrument the flow. Set up dashboards that show value delivered, burn up or cumulative flow, risk trend, and forecast against tolerances. Decide how often the board meets and stick to it.
- Run short feedback loops. After each stage, hold a governance retrospective with the board and the team. Tune roles, templates, and metrics.
- Scale deliberately. When the model works, codify it in a playbook and train project managers, product owners, and board members. Expand to more projects with similar characteristics before tackling the outliers.
This path balances structure with learning so you do not over-engineer too soon.
Metrics and patterns that matter
Pick a small set of measures that tell a coherent story from team to the board members. Tie outcome metrics such as benefits realised, adoption, satisfaction, or risk reduction back to the Business Case. Watch flow through lead time, throughput, work in progress, and percent complete for the stage outcome so bottlenecks surface early. Keep quality visible with escaped defects, automated test coverage, and rework trends.
A few patterns consistently help in a PRINCE2 and Agile implementatoin. Define scope in terms of outcomes and product capabilities so lower value items are easy to flex. Treat the business case as incremental by writing a credible case for the first stage and strengthening or rethinking it as new evidence arrives. Keep stage gates purposeful by focusing on value and viability rather than checklists. Run dual track development so discovery validates assumptions while delivery builds the next most valuable slice. Treat systemic impediments as project level risks with named owners and due dates and review progress at each board session.
Common pitfalls to watch for
The downsides you may experience with this implementation are quite familiar. Duplicating gatherings wastes time, so invite board representatives to a single review and follow it with a short decision meeting. Paperwork expands to fill the space if you let it; when a template grows beyond a few pages, ask whether it still serves a decision and remove what does not. Weak product ownership stalls teams, so invest in the role and pair it with a Senior User who can open doors. Unclear tolerances turn everyday variation into constant escalation, so write them down and socialise them. Avoid promising fixed scope when time and cost are fixed; use prioritisation and communicate trade-offs early.
An example hybrid blueprint
Consider a nine month project to launch a new customer onboarding portal. The sponsor commissions a PRINCE2 project and forms a board with an Executive, a Senior User, and a Senior Supplier. The Project Manager writes a short Business Case and a focused PID that set out the vision, the key constraints, and the risk hot spots.
The first stage runs for ten weeks with objectives that include a working onboarding flow for a pilot segment, integration with a core identity service, and a set of risk assumptions validated through early testing. Two Scrum teams deliver in five two week sprints while the Stage Plan sets tolerances of plus or minus one week on schedule and zero on cost, with scope flexed through MoSCoW and a protected Definition of Done. At each sprint review the Project Manager updates the highlight report to show value delivered, forecast against tolerances, top risks, and any decisions needed from the board.
At the boundary, the teams demonstrate a working pilot. The board reviews early benefits evidence, confirms continued justification, and approves the next stage with funding and refined tolerances. By the end of the project, the portal is live for all customers, benefits are tracked, and the organisation has a repeatable hybrid playbook.
PRINCE2 Agile or tailored PRINCE2?
You have two good routes. If you want ready-made patterns such as fixing time and cost while flexing scope, along with detailed advice on behaviours and controls, adopt the PRINCE2 Agile guidance, especially when teams already use Scrum or Kanban and you need a structured link to governance. If your environment already has strong agile practices and only needs light governance, tailor core PRINCE2 by keeping the principles and processes, simplifying documentation, and leaning on tolerances. Both paths are valid; choose based on your maturity and appetite for change.
Wrapping it all up
Implementing PRINCE2 in an agile environment is less about mixing methods and more about clarifying how decisions are made. Keep the principles, simplify the paperwork, and let teams deliver in short cycles. Fix time and cost at the stage level, flex scope and quality in a controlled way, and keep benefits in sight. When governance and delivery inform each other, PRINCE2 and agile stop competing and start reinforcing results.
